SPEC Update – May/June

SPEC Update – May/June

Current Status

Pool Hall:

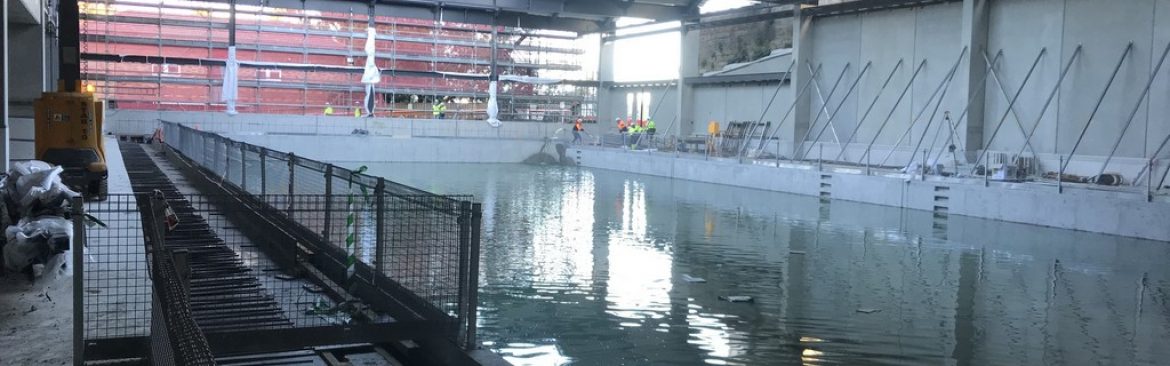

  • The pool structure has been completed and filled to conduct water testing.
  • The metal deck roofing is complete.
  • Installing façade framing to accept glazing.
  • Conducting fire rating for the classrooms above the pool.

Sports Hall:

  • Installing structural steel for the classrooms, roof terraces and roof on levels 3 and 4.
  • Pouring the final concrete for the grandstands on level 2.
  • Stripping and removing formwork and roughing in services.

Car Park:

  • Structural modifications to the existing car park are complete.
  • Installing reinforcing steel to the ground floor slab is ongoing.
  • Stormwater diversions and ramp construction is nearing completion.

Robson Courtyard:

  • Demolition and excavation in the Robson Courtyard are nearing completion.

Next Steps

  • Major concrete pours at Bishopsgate car park.
  • Roughing in services at the Robson Courtyard prior to concrete pours.
  • Emptying the pool for sealing, and enclosing the pool hall structure.

It is anticipated that the structural works on site will be completed in late July.
